Childress
Project of IREN
Where it stands
IREN's Childress, Texas campus has 750MW of planned gross capacity. Horizon 1, the first of four 50MW (IT) liquid-cooled deployments for Microsoft, was delivered and accepted in August 2026, while Horizons 2-4 are in late-stage construction targeting calendar Q4 2026 delivery and Horizons 5-6 are in early site works. Existing Childress capacity (formerly Bitcoin mining) is also operating and being transitioned to AI Cloud, but its MW is not stated; operating_mw counts only Horizon 1's IT load, which is not directly comparable to the 750MW gross figure.
50 MW in service · 150 MW under construction · 750 MW planned
| Phase | MW | Status | Date | Source |
|---|---|---|---|---|
| Horizon 1 | 50 | operational | 2026-08-21 | Delivered Horizon 1 to, and received acceptance from, Microsoft in August 2026. Horizon 1 is the first of four 50MW (IT) liquid-cooled deployments at Childress. 2026-10-12 View cached copy (2026-10-14)Live source ↗ |
| Horizons 2-4 | 150 | under construction | Horizon 2-4 is targeted for delivery in phases in calendar Q4 2026, with grace periods under the Microsoft Agreement for delivery extending from mid-Q4 of calendar 2026 to the beginning of Q2 of calendar 2027. 2026-08-26 View cached copy (2026-08-30)Live source ↗ | |
| Horizons 5-6 | under construction | including late-stage construction of Horizons 1–4 and early site works for Horizons 5–6 at Childress 2026-10-12 View cached copy (2026-10-14)Live source ↗ |
Assessed October 18, 2026 from the newest filings, releases and reporting that name this project (newest relied on: October 12, 2026).
Capacity
What has actually been delivered, against what has been promised. Each figure links to the statement it came from.
| Stage | Capacity | As of | Source |
|---|---|---|---|
| Energized power flowing today | 650 MW | 2025-07-06 | Childress Phase 5 complete, 650MW operating |
| Contracted a customer is on the hook | 480 MW | 2026-05-07 | 2026 Capacity Expansion to 480MW |
| Under construction | 750 MW | 2025-06-04 | Childress second 345kV/138kV transformer on site for full 750MW |
| Permitted | -- | ||
| Interconnect approved utility has agreed to deliver | -- | ||
| Interconnect requested in a queue, nothing approved | -- | ||
| Announced a press-release figure | 750 MW | 2026-08-13 | Childress data center planned capacity |
Who has claimed this site
Capacity commitments in the order they were announced. A commitment that ended shows why.
Claims about this project
Site intelligence
How we located this site
- Initial geocode 2026-09-05
Childress, Texas, TX → town/county centre, 4 km box -- not the site - Starting point (the project's stated locality) 2026-10-19
Childress, Texas → 34.42645, -100.20400 (locality) - No site-level evidence yet 2026-10-19

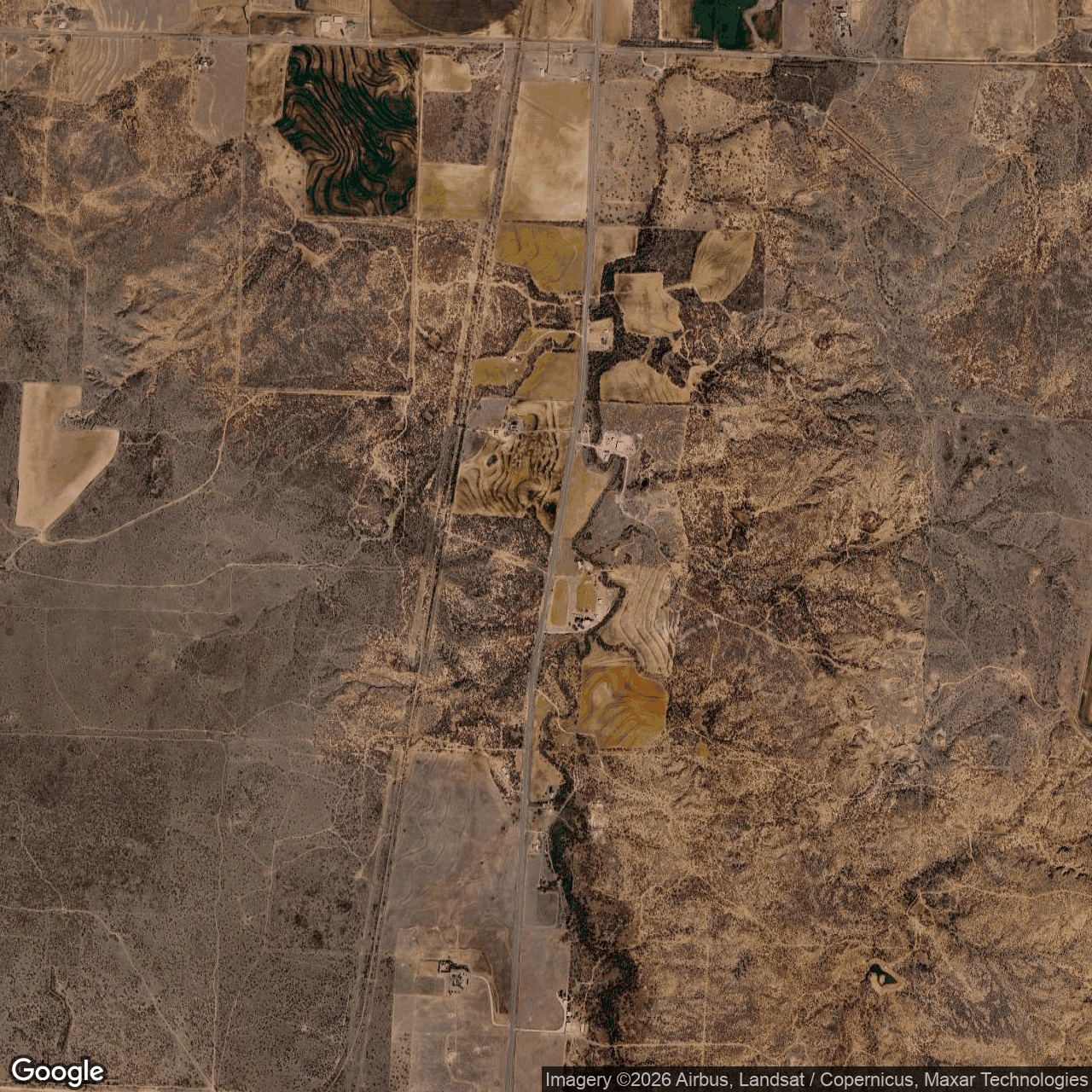

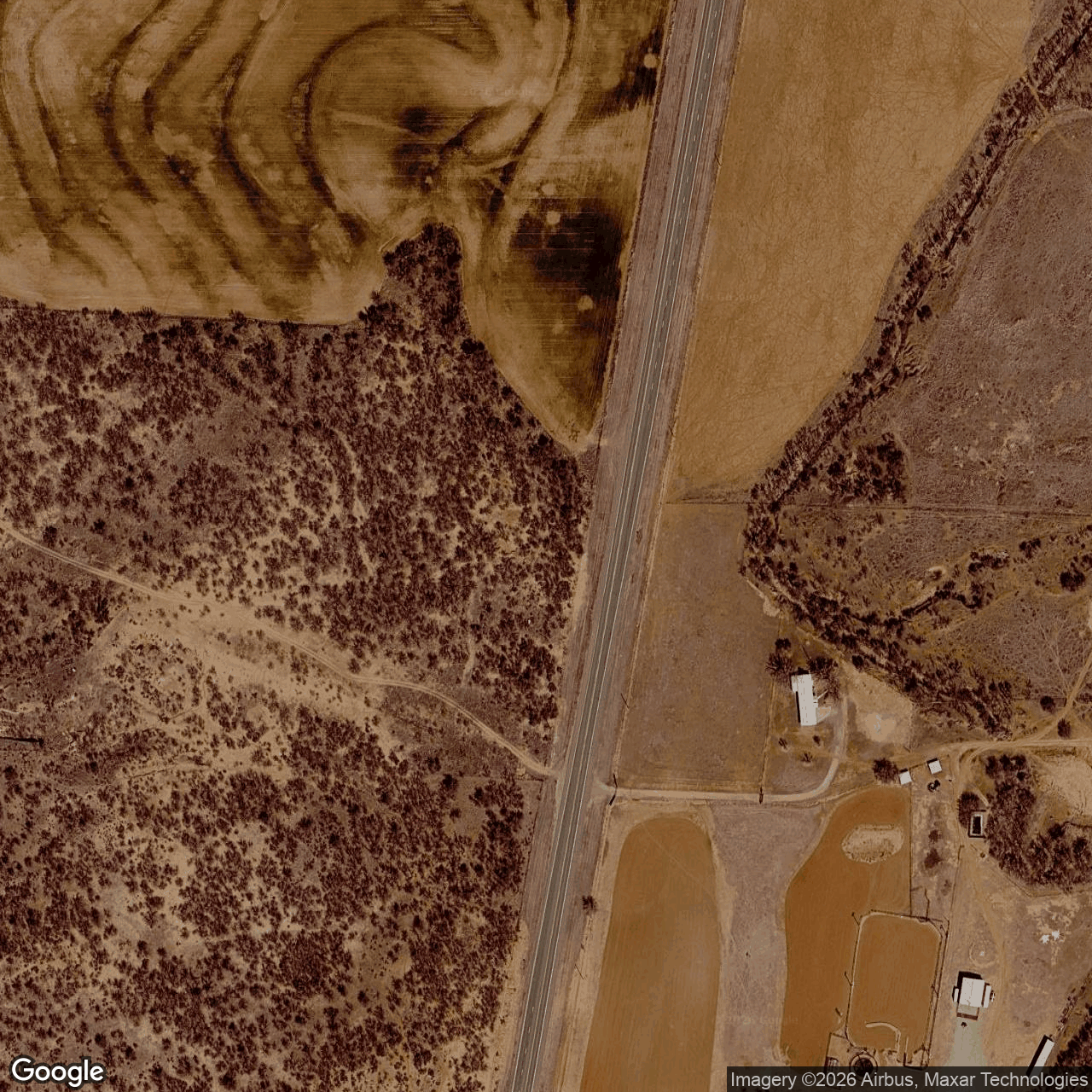

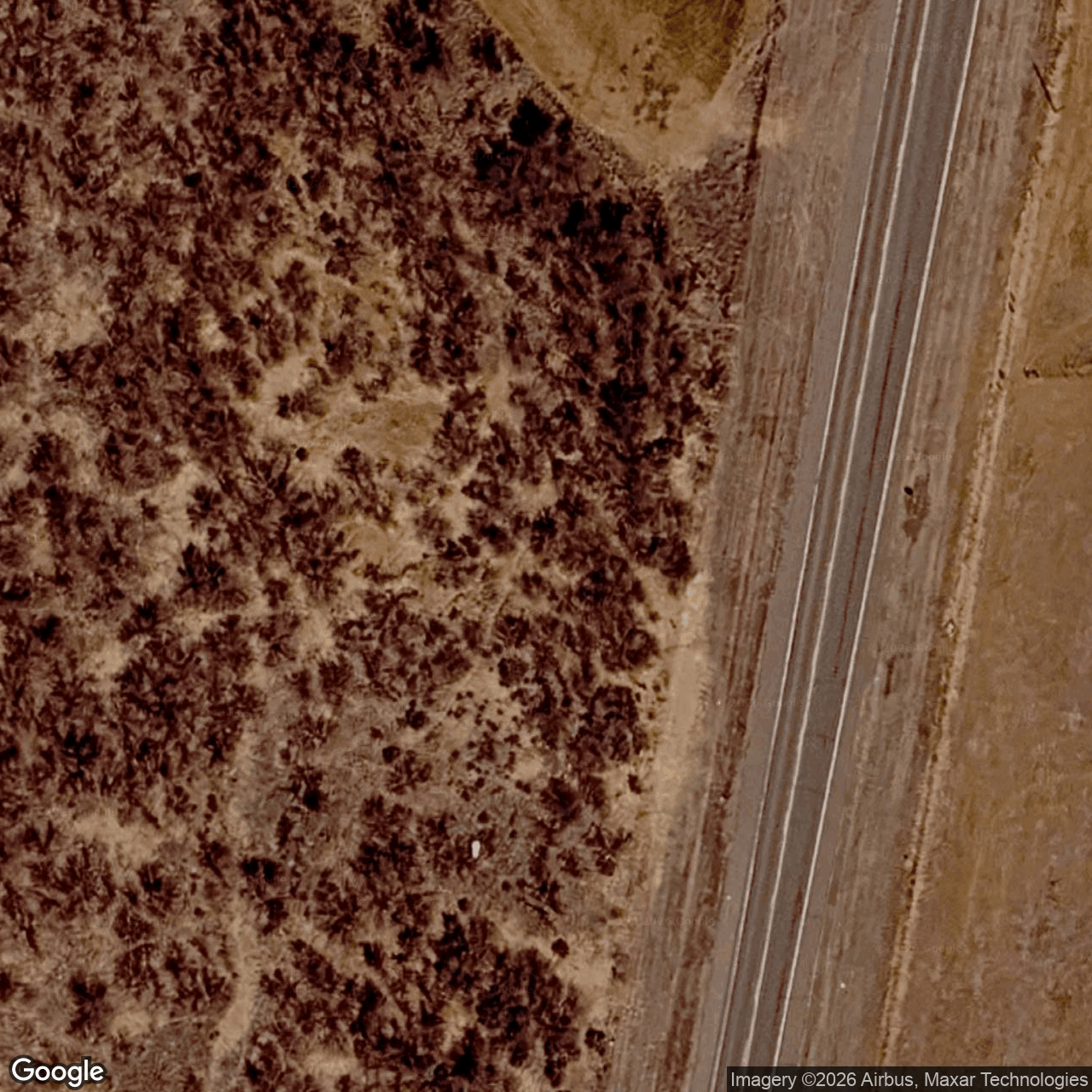

no address, road, landmark or coordinates tie this project to a specific parcel yet -- the town is shown, NOT the site - OpenStreetMap features nearby 2026-10-19
0 named match(es)
