Ellendale
Project of Applied Digital
Where it stands
Applied Digital's Polaris Forge 1 HPC campus in Ellendale is contracted with CoreWeave for 400 MW of critical IT load. Building 1 (100 MW) is operating, and Building 2 (150 MW) reached Ready for Service in October 2026, for 250 MW operational. Building 3 (150 MW) is targeted for 1H 2027 and is reported on schedule. The passages do not say which Ellendale facility sits at 9685 87th Ave SE. If the address is the separate 180 MW crypto-hosting facility (ELN01), that facility is fully operational at 180 MW instead.
250 MW in service · 150 MW under construction · 400 MW planned
| Phase | MW | Status | Date | Source |
|---|---|---|---|---|
| Building 1 (PF1-1) | 100 | operational | In the prior fiscal year, we commenced operations at our first HPC data center at our Polaris Forge 1 campus in Ellendale, North Dakota, with 100 MW of capacity. 2026-10-07 View cached copy (2026-10-08)Live source ↗ | |
| Building 2 (PF1-2) | 150 | ready for service | 2026-10-02 | the addition brings 75 MW of critical IT load across three 25 MW halls, completing Building 2's 150 MW and lifting the campus's fully operational critical IT load to 250 MW. 2026-10-02 View cached copy (2026-10-03)Live source ↗Archive.org ↗ |
| Building 3 (PF1-3) | 150 | under construction | PF1-2 150 MW Calendar - 2H 2026 (16) PF1-3 150 MW Calendar - 1H 2027 (16) 2026-10-08 View cached copy (2026-10-08)Live source ↗Archive.org ↗ |
Assessed October 18, 2026 from the newest filings, releases and reporting that name this project (newest relied on: October 11, 2026).
Capacity
What has actually been delivered, against what has been promised. Each figure links to the statement it came from.
| Stage | Capacity | As of | Source |
|---|---|---|---|
| Energized power flowing today | 180 MW | 2026-10-15 | Ellendale facility capacity |
| Contracted a customer is on the hook | 280 MW | 2023-05-15 | Ellendale North Dakota facility energization March 2023 |
| Under construction | 180 MW | 2026-10-08 | Ellendale ND facility – full 180MW online |
| Permitted | -- | ||
| Interconnect approved utility has agreed to deliver | -- | ||
| Interconnect requested in a queue, nothing approved | -- | ||
| Announced a press-release figure | 600 MW | 2024-04-11 | Ellendale campus future capacity potential |
Who has claimed this site
Capacity commitments in the order they were announced. A commitment that ended shows why.
Claims about this project
Site intelligence
How we located this site
- Starting point (the project's stated locality) 2026-10-19

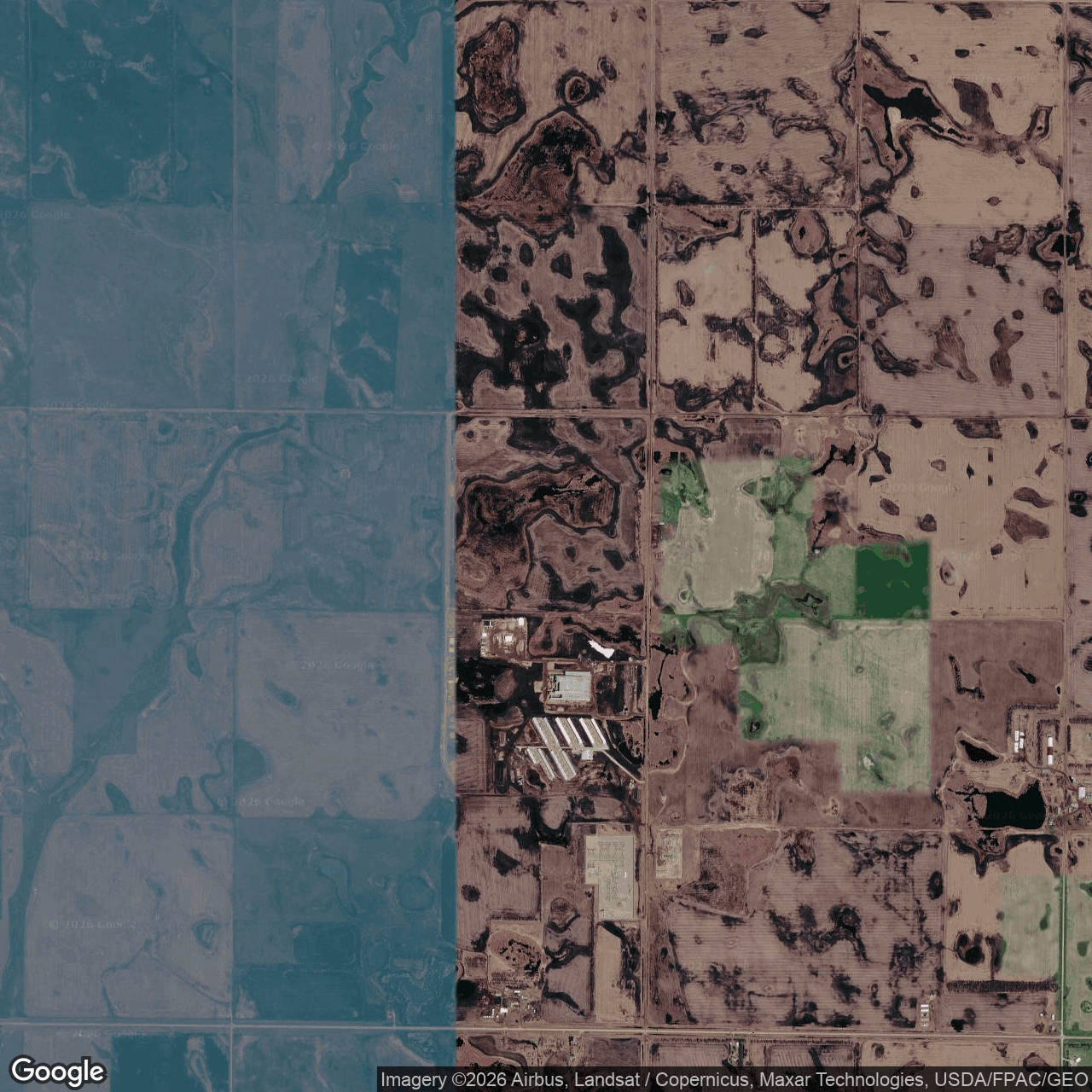

9685 87th Ave SE, Ellendale, ND → 46.00614, -98.56874 (street) - Located from a published address 2026-10-19
Applied Digital / Ellendale Data Center → 46.01339, -98.57331 (footprint), 0.9 km from seed - Located from a published address 2026-10-19
9685 87th Ave SE, Ellendale, ND → 46.00614, -98.56874 (street) - OpenStreetMap features nearby 2026-10-19
1 named match(es)
- 2026-10-10 vs 2026-09-09: clearing or grading visible — Over the 31-day interval, Landsat 8/9 surface reflectance shows decreased NDVI (−0.163) alongside increased NDBI (+0.150) and NDWI (+0.095), a pattern consistent with vegetation removal and exposed soil or graded surfaces at the site.
- 2026-04-10 vs 2026-03-16: new roof or pavement visible
- 2025-07-12 vs 2025-06-18: vegetation recovery visible
- 2026-01-12 vs 2025-12-03: new roof or pavement visible
- 2025-12-15 vs 2025-11-30: new roof or pavement visible
Satellite imagery on this page is drawn from the Google Earth satellite basemap, USDA NAIP aerial photography (~1 m/pixel), ESA Sentinel-2 multispectral (10 m, with per-date cloud masks), NASA / USGS Landsat 8/9 (30 m, plus surface temperature), ESA Sentinel-1 radar (all-weather, night), NASA ECOSTRESS thermal (~70 m), and NASA Black Marble night lights (500 m, daily). Each image is dated, labelled by source and pixel resolution, and downloadable at its native size; cloudy dates are kept and marked rather than hidden. New scenes are pulled daily as each provider publishes them.
