Barber Lake Facility
Project of Cipher Mining
Where it stands
Barber Lake is a 300 MW gross HPC data center near Colorado City, Texas, leased to Fluidstack with a Google backstop. Phase I is 244 MW gross (168 MW critical IT) and Phase II is 56 MW gross (39 MW critical IT). The September 2026 amendment moved delivery to individual data halls between Q4 2026 and Q1 2027, with first rent expected in Q4 2026; no passage confirms any hall has been delivered yet. The phase dates shown are the original 10-K targets, which the amendment has superseded.
300 MW under construction · 300 MW planned
| Phase | MW | Status | Date | Source |
|---|---|---|---|---|
| Phase I | 244 | under construction | 2026-09-30 | 244 MW of gross capacity will be allocated to Fluidstack in Barber Lake Phase I, and the remaining 56 MW will be allocated to Fluidstack in Barber Lake Phase II. 2026-02-23 View cached copy (2026-08-31)Live source ↗ |
| Phase II | 56 | under construction | 2027-01-31 | Cipher Barber Lake is targeting delivery of Barber Lake Phase I by September 30, 2026, and of Barber Lake Phase II by January 31, 2027. 2026-02-23 View cached copy (2026-08-31)Live source ↗ |
Assessed October 18, 2026 from the newest filings, releases and reporting that name this project (newest relied on: September 24, 2026).
Capacity
What has actually been delivered, against what has been promised. Each figure links to the statement it came from.
| Stage | Capacity | As of | Source |
|---|---|---|---|
| Energized power flowing today | 300 MW | 2025-05-05 | Barber Lake 300 MW approved and energized |
| Contracted a customer is on the hook | 300 MW | 2026-06-07 | Barber Lake Fluidstack/Google data center |
| Under construction | 168 MW IT load | 2025-09-24 | Barber Lake facility capacity |
| Permitted | -- | ||
| Interconnect approved utility has agreed to deliver | 300 MW | 2025-08-06 | Barber Lake approved power |
| Interconnect requested in a queue, nothing approved | -- | ||
| Announced a press-release figure | 800 MW | 2025-09-24 | Barber Lake Phase I 300 MW / Phase II 500 MW |
Who has claimed this site
Capacity commitments in the order they were announced. A commitment that ended shows why.
Claims about this project
Site intelligence

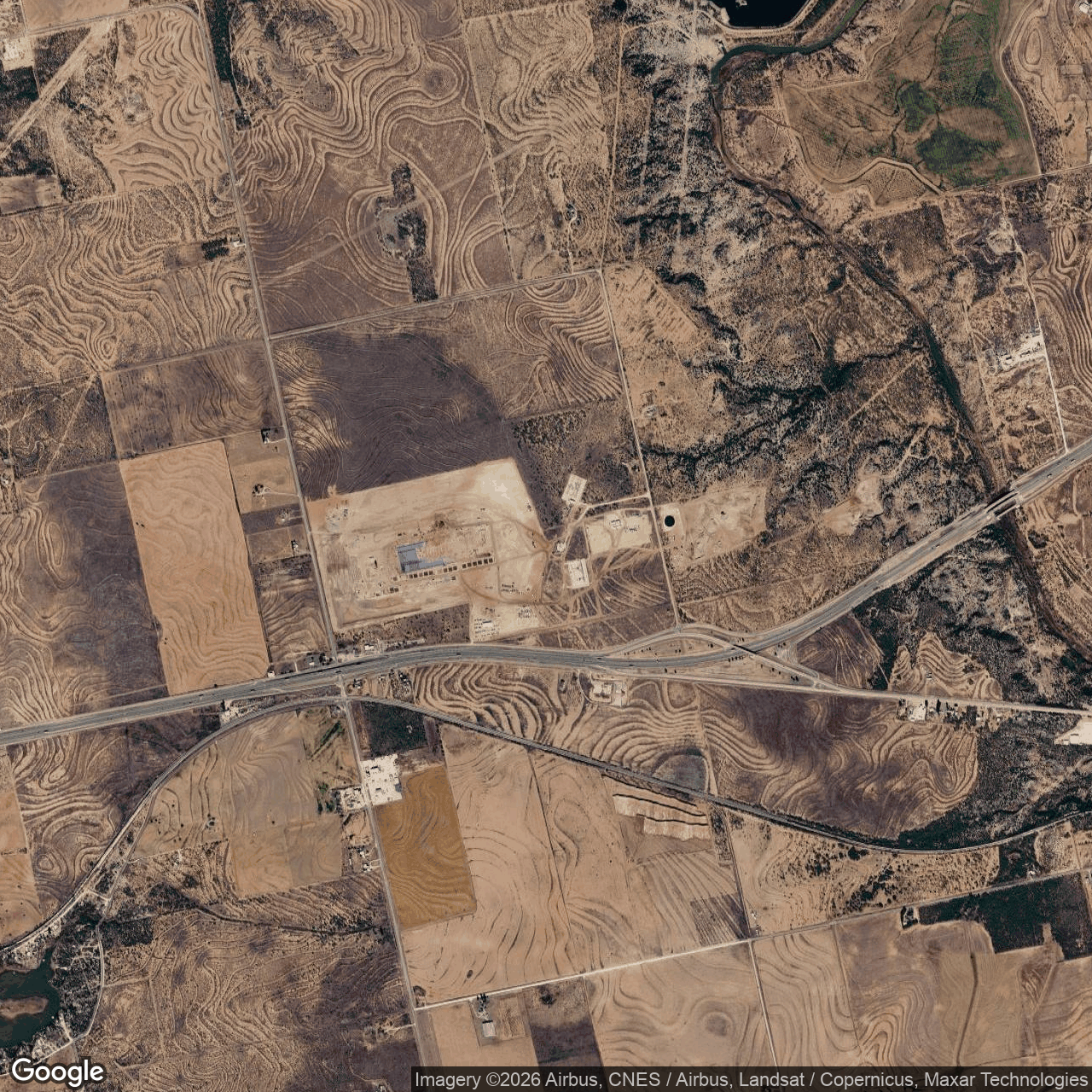

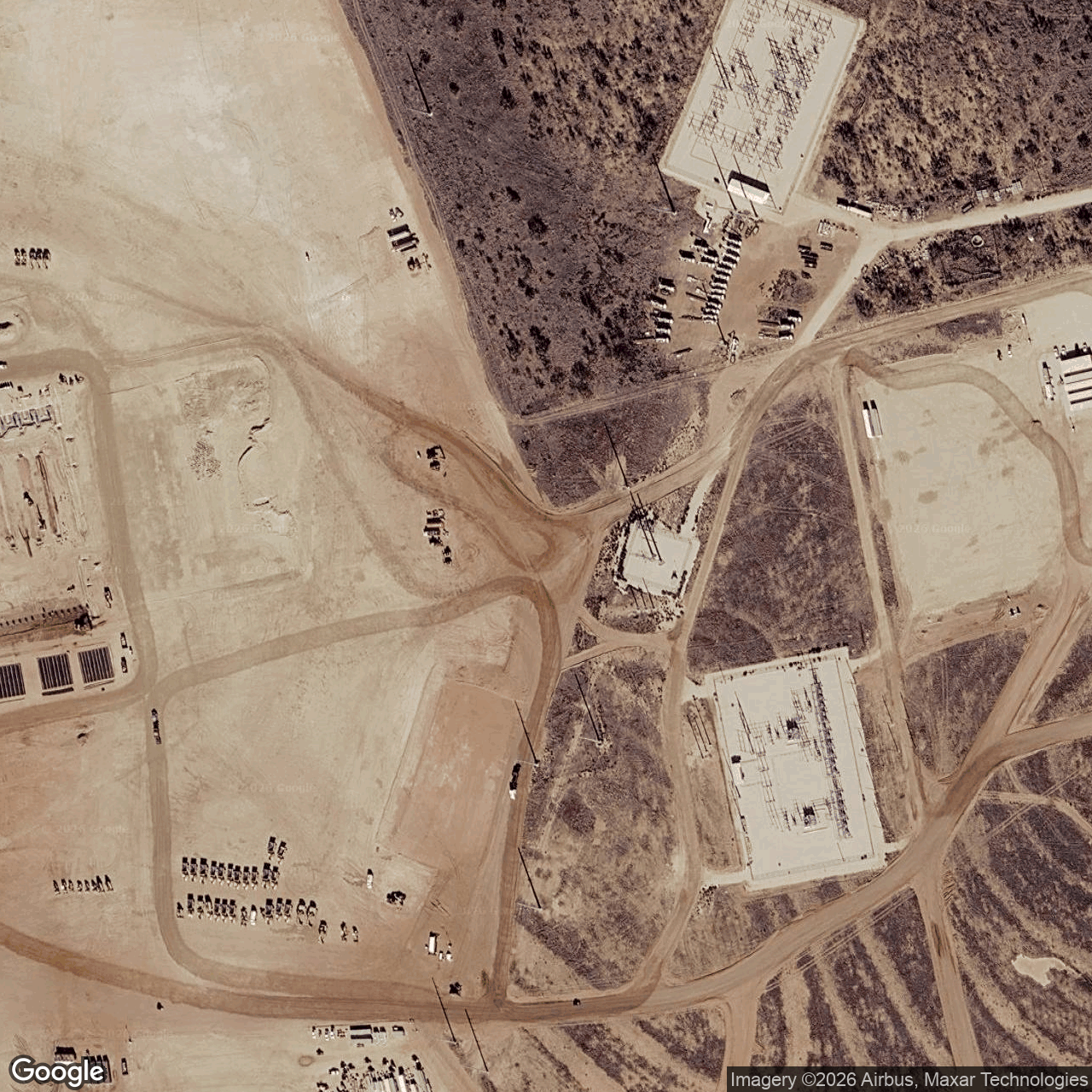

How we located this site
- Starting point (the project's stated locality) 2026-10-19
951 County Road 204, Colorado City, TX 79512 → 32.39676, -100.91203 (rooftop) - Located from a published address 2026-10-19
951 County Road 204, Colorado City, TX 79512 → 32.39676, -100.91203 (rooftop) - OpenStreetMap features nearby 2026-10-19
0 named match(es)
- 2026-04-18 vs 2026-04-06: structural change (radar signal shift)
- 2026-07-06 vs 2026-06-17: structural change (radar signal shift)
- 2024-08-14 vs 2024-07-21: structural change (radar signal shift)
- 2024-07-21 vs 2024-06-15: structural change (radar signal shift)
- 2024-12-12 vs 2024-11-18: structural change (radar signal shift)
Satellite imagery on this page is drawn from the Google Earth satellite basemap, USDA NAIP aerial photography (~1 m/pixel), ESA Sentinel-2 multispectral (10 m, with per-date cloud masks), NASA / USGS Landsat 8/9 (30 m, plus surface temperature), ESA Sentinel-1 radar (all-weather, night), NASA ECOSTRESS thermal (~70 m), and NASA Black Marble night lights (500 m, daily). Each image is dated, labelled by source and pixel resolution, and downloadable at its native size; cloudy dates are kept and marked rather than hidden. New scenes are pulled daily as each provider publishes them.
