Black Pearl Facility
Project of Cipher Mining
Where it stands
Cipher is retrofitting the 300 MW Black Pearl Facility in Wink, Texas, a former bitcoin mine, for a 15-year hyperscaler HPC lease of about 300 gross MW. A July 24, 2026 lease amendment accelerated delivery of first capacity to July 31, 2026. An August 2026 news piece, based on social media commentary, says the facility came online early and is generating rent; the delivered MW is not stated, and full ramp was targeted for Q1 2027.
300 MW planned
| Phase | MW | Status | Date | Source |
|---|---|---|---|---|
| Phase I (initial subphase) | operational | 2026-07-31 | On July 24, 2026, we amended the HPC lease at the Black Pearl Facility, which accelerated delivery of the first capacity to July 31, 2026. 2026-08-03 View cached copy (2026-08-30)Live source ↗ | |
| Phase II (initial subphase) | planned | Cipher Black Pearl is targeting rent commencement for the initial subphase of Black Pearl Phase I by the fourth quarter of 2026 and the initial subphase for Black Pearl Phase II by the first quarter of 2027. 2026-02-23 View cached copy (2026-08-31)Live source ↗ |
Assessed October 18, 2026 from the newest filings, releases and reporting that name this project (newest relied on: August 22, 2026).
Capacity
What has actually been delivered, against what has been promised. Each figure links to the statement it came from.
| Stage | Capacity | As of | Source |
|---|---|---|---|
| Energized power flowing today | 150 MW | 2025-08-06 | Black Pearl Phase I energization |
| Contracted a customer is on the hook | 300 MW | 2026-06-07 | Black Pearl AWS data center |
| Under construction | 300 MW | 2026-08-03 | Black Pearl Facility capacity |
| Permitted | -- | ||
| Interconnect approved utility has agreed to deliver | 300 MW | 2023-11-07 | Black Pearl ERCOT power approval |
| Interconnect requested in a queue, nothing approved | -- | ||
| Announced a press-release figure | 300 MW | 2026-02-23 | Black Pearl 300 MW HPC capacity |
Who has claimed this site
Capacity commitments in the order they were announced. A commitment that ended shows why.
Claims about this project
Site intelligence

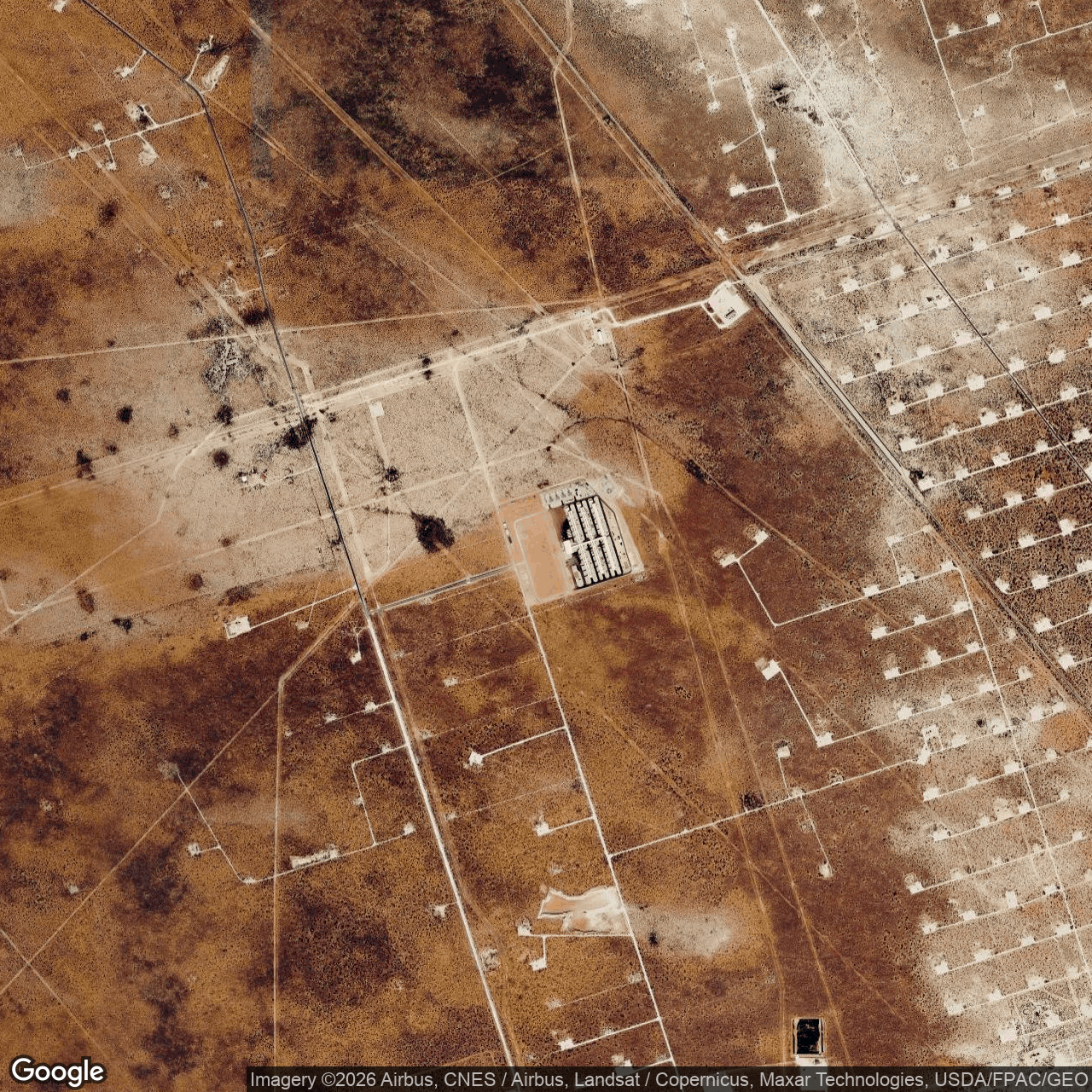

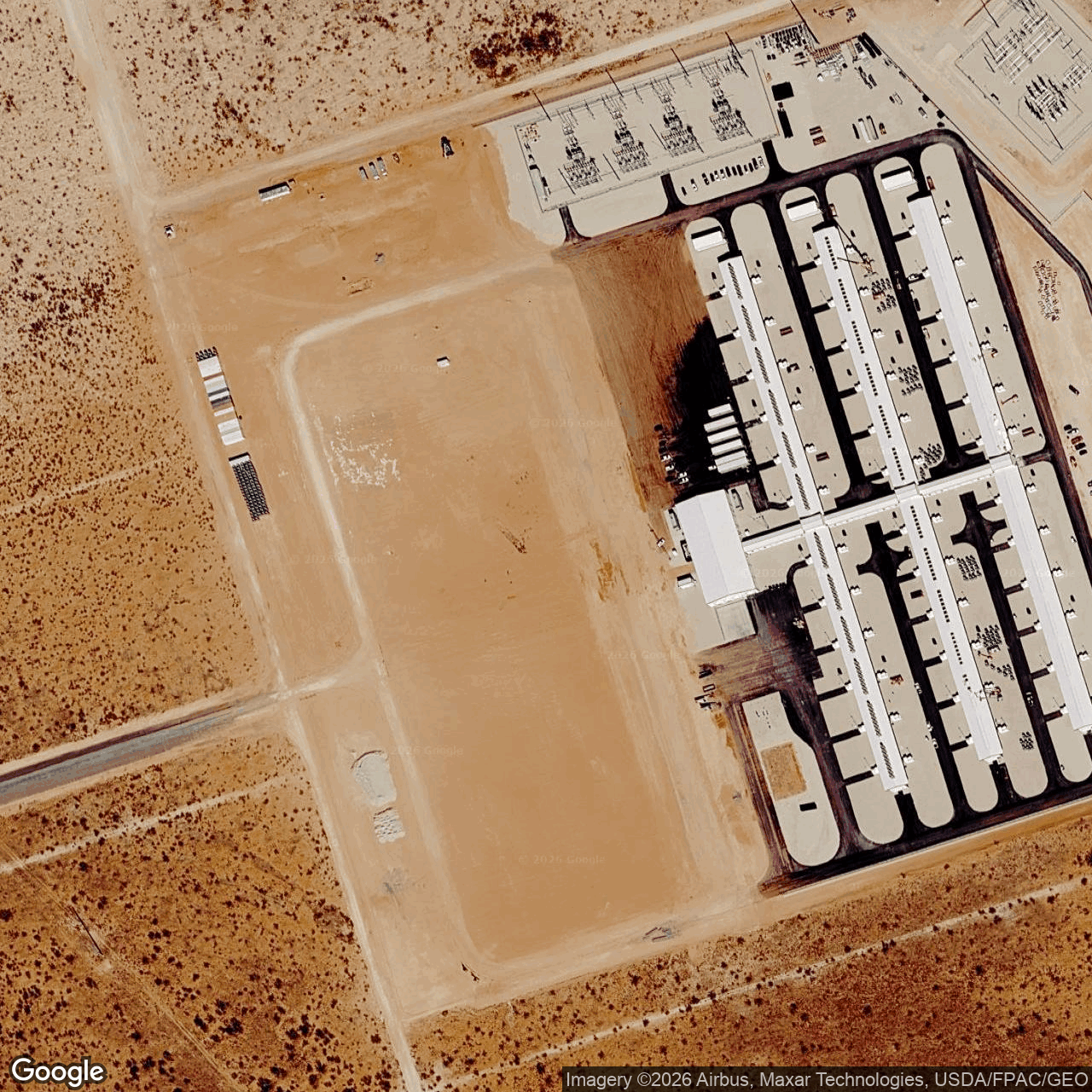

How we located this site
- Starting point (the project's stated locality) 2026-10-19
11786 County Road 209, Wink, TX 79789 → 31.69452, -103.08288 (street) - Located from a published address 2026-10-19
11786 County Road 209, Wink, TX 79789 → 31.69452, -103.08288 (street) - OpenStreetMap features nearby 2026-10-19
0 named match(es)
- 2025-10-20 vs 2025-10-13: structural change (radar signal shift)
- 2025-10-13 vs 2025-09-19: structural change (radar signal shift)
- 2026-08-11 vs 2026-07-17: structural change (radar signal shift)
- 2026-07-17 vs 2026-07-11: structural change (radar signal shift)
Satellite imagery on this page is drawn from the Google Earth satellite basemap, USDA NAIP aerial photography (~1 m/pixel), ESA Sentinel-2 multispectral (10 m, with per-date cloud masks), NASA / USGS Landsat 8/9 (30 m, plus surface temperature), ESA Sentinel-1 radar (all-weather, night), NASA ECOSTRESS thermal (~70 m), and NASA Black Marble night lights (500 m, daily). Each image is dated, labelled by source and pixel resolution, and downloadable at its native size; cloudy dates are kept and marked rather than hidden. New scenes are pulled daily as each provider publishes them.
