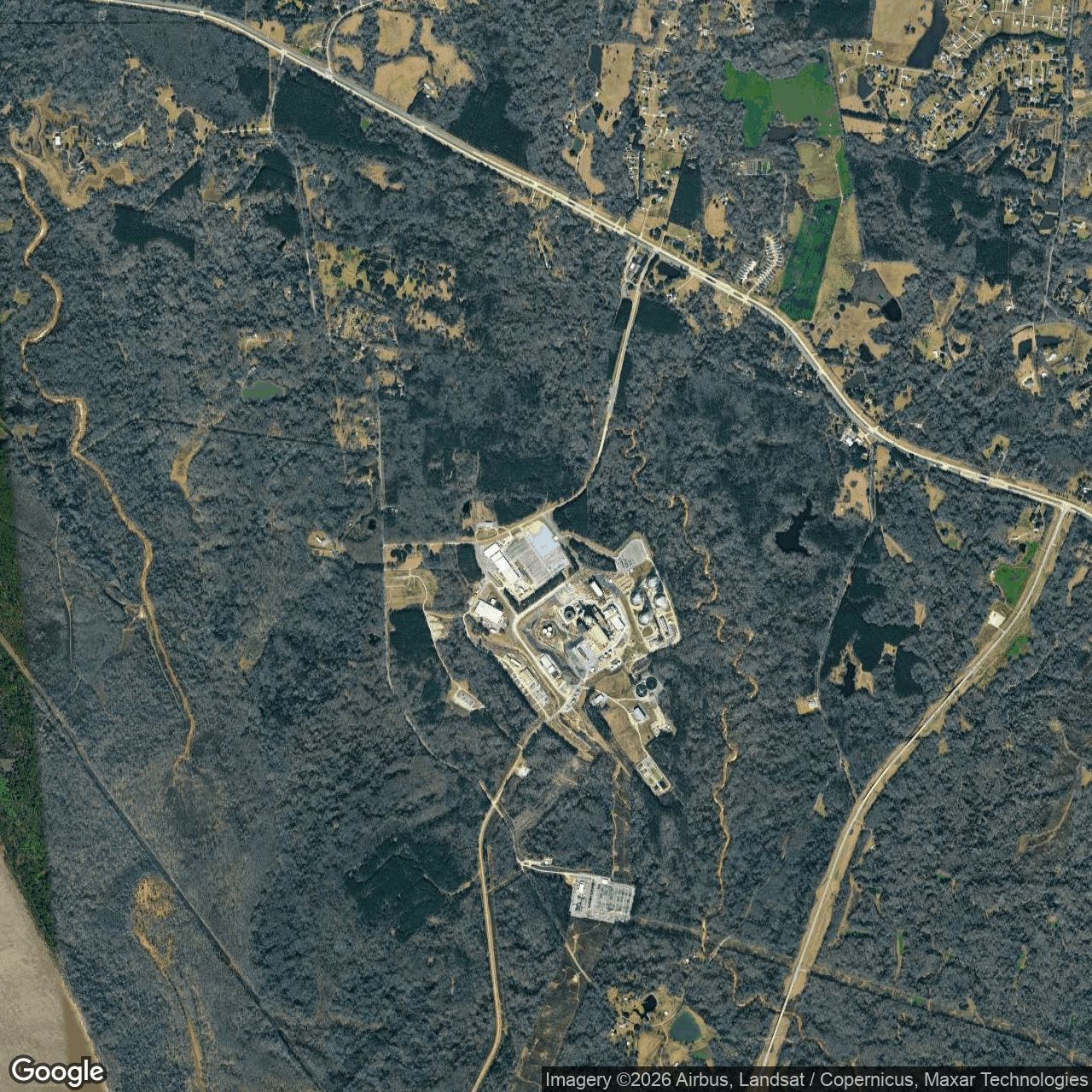

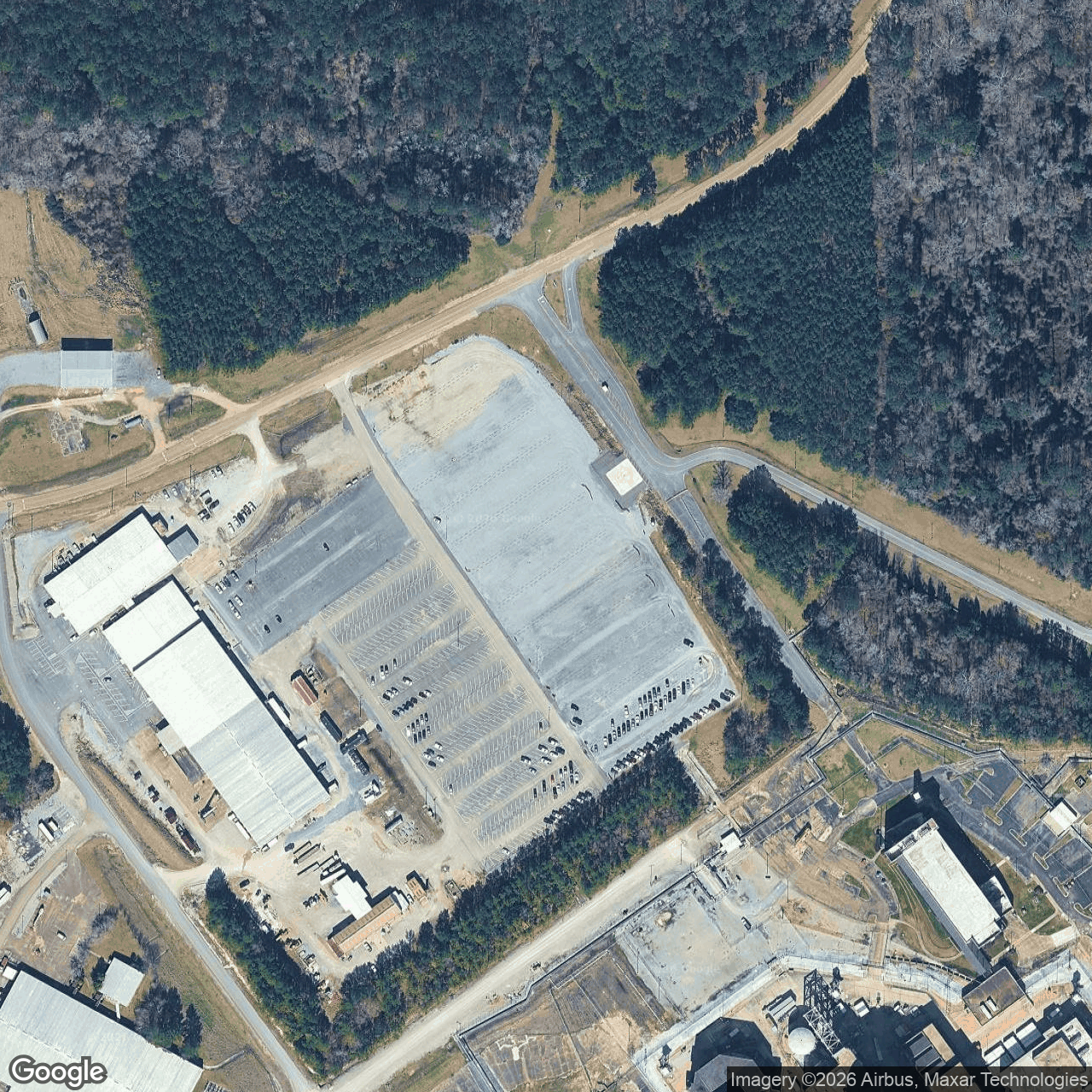

River Bend
Project of Hut 8
Capacity
What has actually been delivered, against what has been promised. Each figure links to the statement it came from.
| Stage | Capacity | As of | Source |
|---|---|---|---|
| Energized power flowing today | -- | ||
| Contracted a customer is on the hook | 245 MW | 2026-09-01 | River Bend 15-year Fluidstack lease 245 MW |
| Under construction | 245 MW IT load | 2026-04-30 | River Bend Data Center Project Capacity |
| Permitted | -- | ||
| Interconnect approved utility has agreed to deliver | -- | ||
| Interconnect requested in a queue, nothing approved | -- | ||
| Announced a press-release figure | 2,295 MW | 2026-09-01 | Hut 8 AI data center capacity commitment |
Who has claimed this site
Capacity commitments in the order they were announced. A commitment that ended shows why.
2025-12-01
Fluidstack - tenant · 245 MW · 15-year term source
2025-12-01
Google - guarantor · 15-year term source
2026-04-27
Anthropic - offtaker source
2026-09-01
Fluidstack - jv partner source
Claims about this project
2025-12-01 - stated
2025-12-01 - stated
2025-12-01 - stated
Fluidstack 15-year lease, River Bend, 245 MW, $7B 7000000000.0 USD.
2025-12-16 - stated
2025-12-16 - stated
2025-12-16 - stated
2026-02-24 - stated
River Bend 15-year triple-net lease 245.0 MW.
2026-02-24 - stated
2026-02-24 - stated
River Bend triple-net lease 245.0 MW.
2026-02-24 - stated
2026-02-24 - stated
River Bend triple-net lease IT capacity 245.0 MW.
2026-02-24 - stated
2026-02-24 - stated
2026-04-26 - stated
Senior Secured Notes Offering 3248.0 USD.
2026-04-26 - stated
River Bend Data Center Project 245.0 MW.
2026-04-27 - stated
Anthropic AI infrastructure partnership 2295.0 MW.
2026-04-27 - stated
Fluidstack 15-year IT lease at River Bend 7000000000.0 USD.
2026-04-27 - stated
$3.25 billion Senior Secured Notes offering 3250000000.0 USD.
2026-04-30 - stated
River Bend Data Center Project Capacity 245.0 MW.
2026-04-30 - stated
2026-04-30 - stated
2026-04-30 - stated
Senior Secured Notes Principal Amortization Schedule. Promised by 2028-05-15.
2026-04-30 - stated
Senior Secured Notes Interest Rate 6.192 percent.
2026-08-04 - stated
2026-08-04 - stated
Total contracted AI data center capacity 949.0 MW.
2026-08-04 - stated
2026-08-04 - stated
River Bend initial data hall delivery targeted. Promised by 2027-06-30.
2026-08-04 - stated
River Bend data hall delivery timeline. Promised by 2027-04-01.
2026-08-21 - stated
2026-08-21 - stated
2026-08-21 - stated
2026-08-21 - stated
2026-08-31 - stated
River Bend first data halls online Q2 2027. Promised by 2027-04-01.
2026-08-31 - stated
15-year $7 billion lease with Fluidstack for 245 MW Louisiana data center 245.0 MW. Promised by 2027-06-30.
2026-08-31 - stated
2026-08-31 - stated
River Bend data center first data halls online. Promised by 2027-06-30.
2026-08-31 - stated
Fluidstack $7 billion 15-year lease for 245 MW 7000000000.0 USD.
2026-08-31 - stated
2026-09-01 - stated
River Bend AI data center capacity provision 2295.0 MW.
2026-09-01 - stated
River Bend project capacity delivery start. Promised by 2027-06-30.
2026-09-01 - stated
River Bend campus lease with Fluidstack, 245 MW, 15-year, $7B 7000000000.0 USD.
2026-09-01 - stated
2026-09-01 - stated
2026-09-01 - stated
River Bend capacity delivery. Promised by 2027-06-30.
2026-09-01 - stated
2026-09-01 - stated
River Bend lease with Fluidstack 7.0 billion USD.
2026-09-01 - stated
Hut 8 AI data center capacity commitment 2295.0 MW.
2026-09-01 - stated
River Bend Fluidstack lease 7.0 USD.
2026-09-01 - stated
River Bend delivery start. Promised by 2027-06-30.
2026-09-01 - stated
River Bend Fluidstack 15-year lease 7.0 USD.
2026-09-01 - stated
River Bend capacity delivery Q2 2027. Promised by 2027-06-30.
2026-09-01 - stated
2026-09-02 - stated
