Muskogee
Project of Core Scientific
Where it stands
Core Scientific plans to scale its Muskogee, Oklahoma campus to about 1.5 GW gross (about 1.0 GW leasable) and closed the $444M Polaris DS acquisition on August 14, 2026, securing about 440 MW of grid-connected power under OG&E agreements. A 70 MW facility leased for NVIDIA GB300 was reported in final testing and expected to become operational in Q2 2026, but no passage confirms it entered service. The next 82-82.5 MW delivery is dated H2 2027 in one passage and Q4 2027 in another, and the 440 MW is power capacity rather than leased data-center capacity, so operating MW is left null.
1,500 MW planned
| Phase | MW | Status | Date | Source |
|---|---|---|---|---|
| 70 MW GB300 facility (existing tenant) | 70 | ready for service | the Muskogee campus already has one active tenant, with a 70 MW facility leased and built to support NVIDIA’s GB300 platform 2026-08-18 View cached copy (2026-08-31)Live source ↗ | |
| Polaris DS acquisition (grid power) | 440 | planned | 2026-08-14 | Core Scientific completed its Polaris DS acquisition on August 14, adding about 440 megawatts of grid-connected power capacity for roughly $444 million in cash 2026-08-20 View cached copy (2026-08-31)Live source ↗ |
| Initial expansion building | 82.5 | planned | An initial 82.5 MW building is slated for delivery in Q4 2027. 2026-08-19 View cached copy (2026-08-31)Live source ↗ |
Assessed October 18, 2026 from the newest filings, releases and reporting that name this project (newest relied on: August 31, 2026).
Capacity
What has actually been delivered, against what has been promised. Each figure links to the statement it came from.
| Stage | Capacity | As of | Source |
|---|---|---|---|
| Energized power flowing today | 100 MW | 2026-03-01 | Muskogee, Oklahoma facility |
| Contracted a customer is on the hook | 440 MW | 2026-09-26 | Muskogee, OK Expansion Capacity Post-Polaris |
| Under construction | 100 MW | 2026-09-01 | Muskogee OK facility capacity in development |
| Permitted | -- | ||
| Interconnect approved utility has agreed to deliver | -- | ||
| Interconnect requested in a queue, nothing approved | -- | ||
| Announced a press-release figure | 1,500 MW | 2026-08-31 | Muskogee campus power expansion |
Who has claimed this site
Capacity commitments in the order they were announced. A commitment that ended shows why.
Claims about this project
Site intelligence
How we located this site
- Starting point (the project's stated locality) 2026-10-19
Muskogee, Oklahoma → 35.74788, -95.36969 (locality) - Located from a published address 2026-10-19

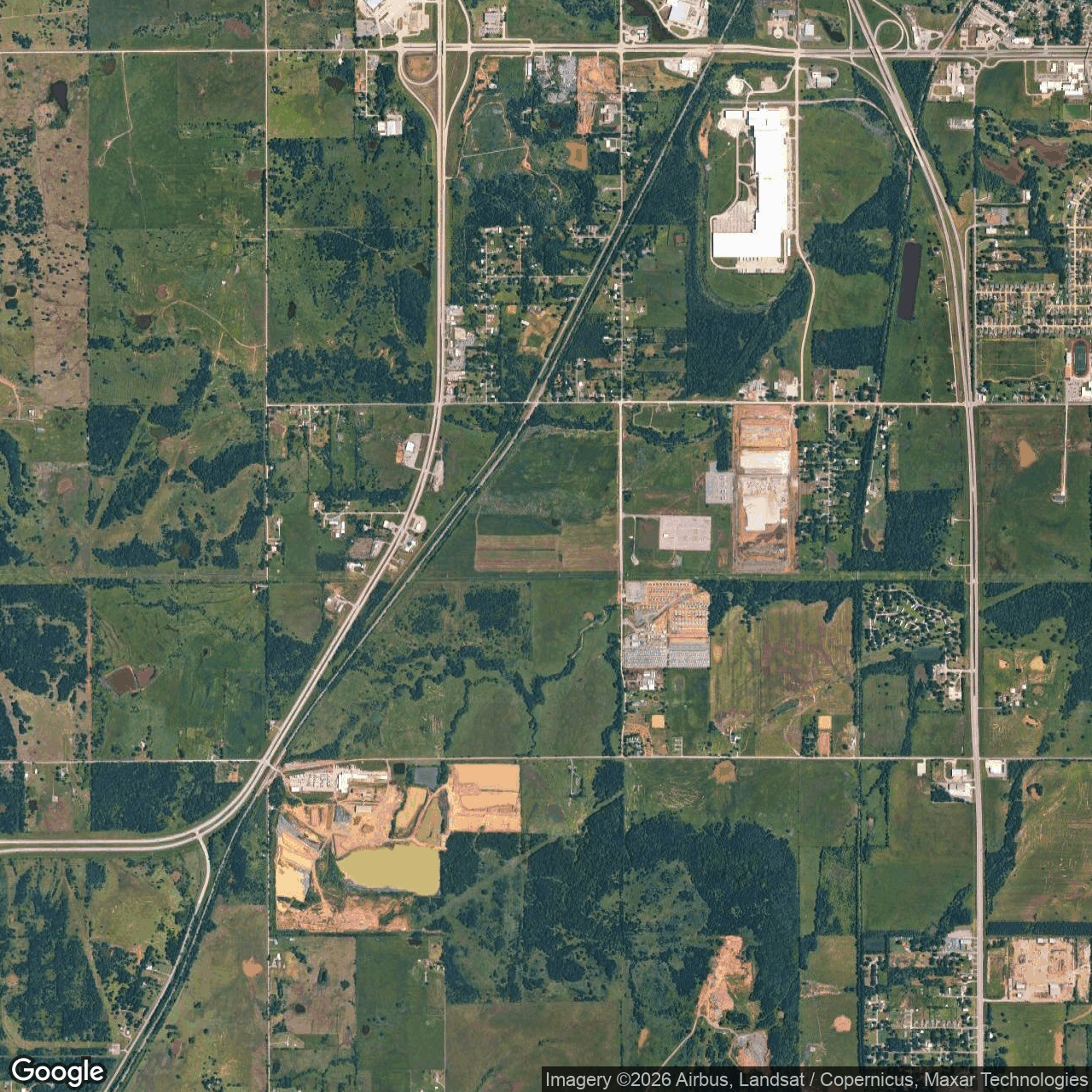

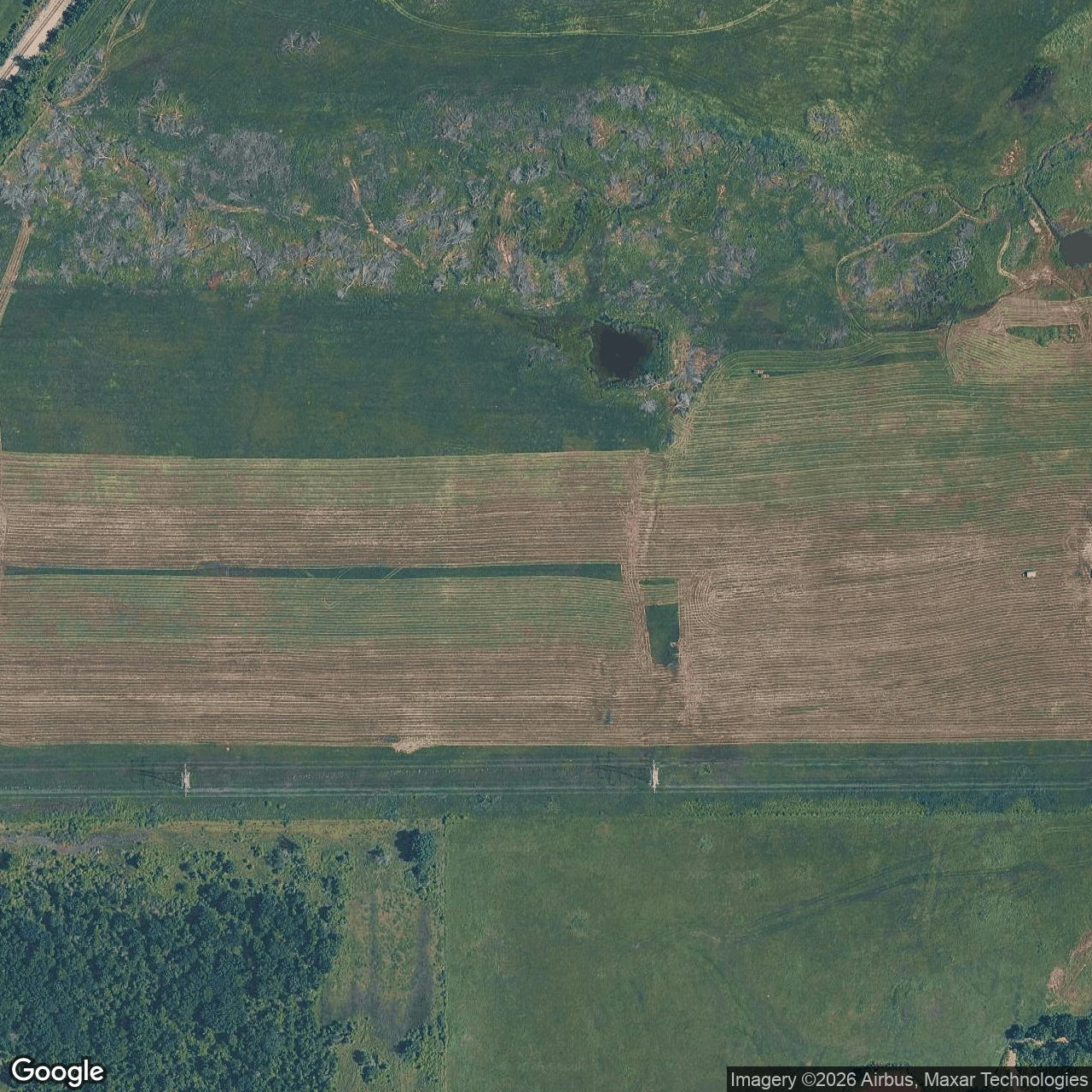

1525 W. Smith Ferry Road → 35.69695, -95.38449 (street), 5.8 km from seed - OpenStreetMap features nearby 2026-10-19
0 named match(es)
- 2023-12-10 vs 2023-10-14: vegetation recovery visible
- 2024-04-07 vs 2024-02-20: vegetation recovery visible
- 2025-05-20 vs 2025-04-10: vegetation recovery visible
- 2025-05-20 vs 2025-04-10: vegetation recovery visible
Satellite imagery on this page is drawn from the Google Earth satellite basemap, USDA NAIP aerial photography (~1 m/pixel), ESA Sentinel-2 multispectral (10 m, with per-date cloud masks), NASA / USGS Landsat 8/9 (30 m, plus surface temperature), ESA Sentinel-1 radar (all-weather, night), NASA ECOSTRESS thermal (~70 m), and NASA Black Marble night lights (500 m, daily). Each image is dated, labelled by source and pixel resolution, and downloadable at its native size; cloudy dates are kept and marked rather than hidden. New scenes are pulled daily as each provider publishes them.
